- test :
Upgrading HVAC systems in schools can be done without disrupting classes. Here’s the key: plan strategically around the school calendar, choose easy-to-install equipment, and manage noise and comfort effectively during construction.
- Timing is crucial: Schedule major upgrades during summer breaks, medium tasks over winter/spring breaks, and minor fixes on weekends or after hours.
- Phased implementation: Tackle projects in sections to keep most of the school operational and spread out costs.
- Smart equipment choices: Modular or pre-assembled systems reduce installation time and minimize classroom disruptions.
- Noise control: Schedule loud tasks outside teaching hours, use barriers, and install quiet HVAC systems.
- Maintain comfort: Use portable heating/cooling units and temporary solutions to ensure classrooms remain comfortable during upgrades.
- Professional contractors: Work with experienced teams to streamline planning, logistics, and safety.
Schedule Upgrades Around the School Calendar

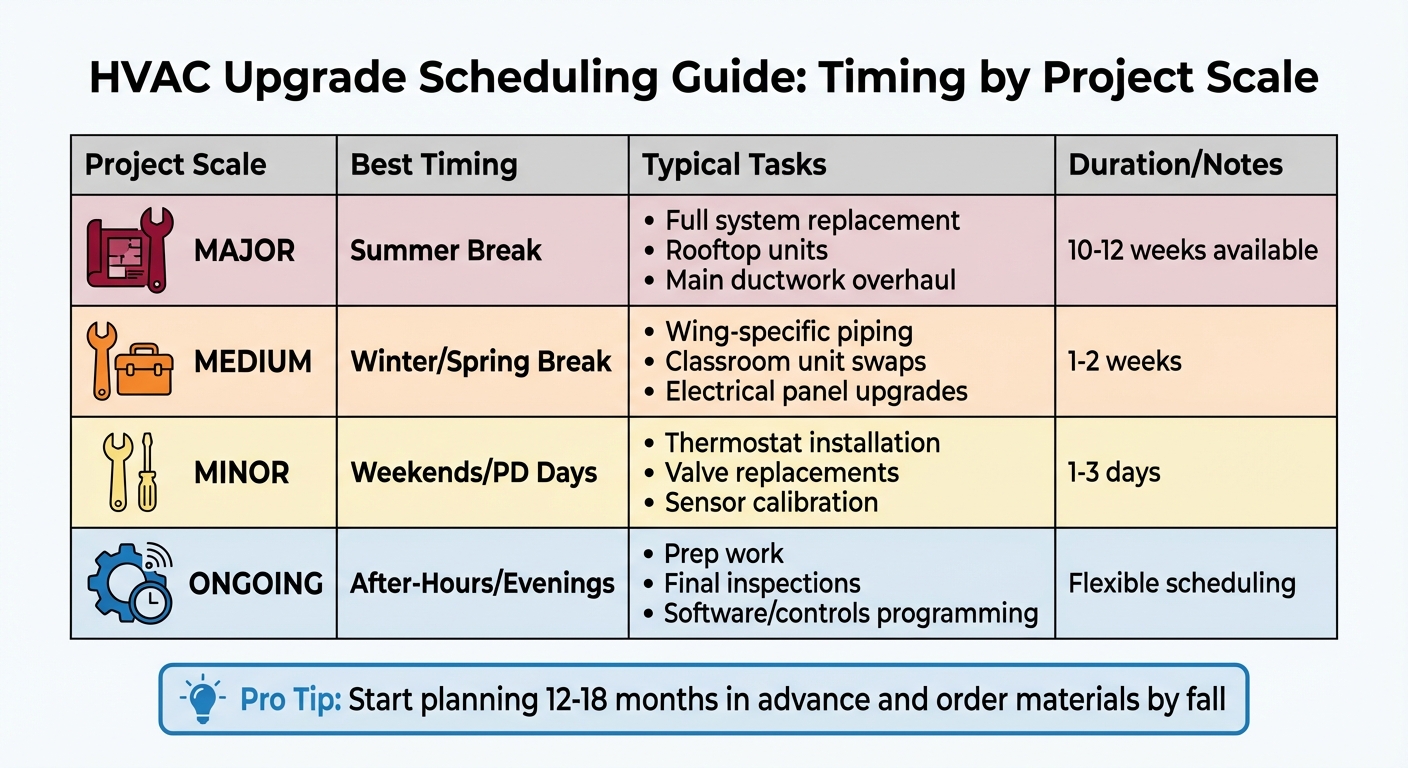

HVAC Upgrade Scheduling Guide for Schools by Project Scale
Timing HVAC upgrades to match school schedules can significantly reduce disruptions. Aligning work intensity with building occupancy ensures minimal interference with learning.
Target Low-Occupancy Periods
Choosing the right time for each project size is key to minimizing classroom interruptions. Summer break is ideal for large-scale upgrades. With schools empty, contractors can shut down systems, move equipment freely, and complete major tasks like installing rooftop units or overhauling ductwork during the 10–12 weeks available [2] [4].
"If the job shuts down the whole school or impacts water and air throughout the building, summer is likely your best bet."
- Lisa Flynn, Harold Brothers Mechanical [4]
For medium-sized projects, such as updating classroom HVAC units or piping, winter and spring breaks are perfect. Smaller tasks – like replacing thermostats or fixing valves – can be handled during long weekends or teacher professional development days. After-hours or weekend work can also address isolated areas, like installing new controls [4] [5].
To ensure a smooth process, start planning 12–18 months in advance and order materials by the previous fall to avoid supply chain delays [2] [4].
Create a Phased Implementation Plan
Strategic timing works best when paired with a phased approach. Phased implementation divides the project into manageable sections, allowing work to occur during multiple low-occupancy periods. Schools can tackle one building or zone at a time, keeping most of the campus functional while avoiding peak contractor demand during the summer. This method also spreads costs over time, offering financial flexibility [4] [5].
A great example of this approach is Lawrence Public Schools USD 497 in Kansas, which modernized its 1954-era Lawrence High School between 2018 and 2021. Partnering with Henderson Engineers, the district divided the project into seven phases over three years, upgrading HVAC, lighting, and plumbing while keeping the school operational [6].
To minimize disruption, isolate work zones using physical barriers and HEPA-filtered air scrubbers to control dust and noise. Portable heating and cooling units can maintain comfort in occupied areas while retrofits are underway elsewhere [2] [5]. This strategy ensures students and teachers experience minimal inconvenience while improving energy efficiency and maintaining classroom stability.
| Project Scale | Timing | Typical Tasks |
|---|---|---|
| Major | Summer Break | Full system replacement, rooftop units, main ductwork |
| Medium | Winter/Spring Break | Wing-specific piping, classroom unit swaps, electrical panel upgrades |
| Minor | Weekends/PD Days | Thermostat installation, valve replacements, sensor calibration |
| Ongoing | After-Hours | Prep work, final inspections, software/controls programming |
Communicate Effectively
Clear communication is just as critical as planning. At Historic Hillsborough High School in Tampa, JE Dunn Construction completed a $16 million HVAC overhaul in 2025 by moving students out of six classrooms at a time. Success relied on providing teachers and students with schedules four to six weeks in advance and offering weekly updates on classroom locations [7].
"Teachers and students must know weeks in advance when and where their classes will move. Providing four to six weeks of schedules creates predictability, and even a simple weekly update to students… helps avoid confusion and builds trust throughout the project."
- Curtis DeLaquil, Group Manager, JE Dunn Construction [7]
sbb-itb-034f8e1
Choose HVAC Equipment That’s Easy to Install
Building on effective scheduling, picking HVAC systems designed for quick and efficient installation can further reduce interruptions in the classroom.
The right equipment can make a huge difference in installation time, helping schools maintain normal operations. The trick? Opt for systems that are ready to go as soon as they arrive – no complicated on-site assembly or coordination between multiple contractors required.
Use Modular or Pre-Assembled Systems
Factory-packaged systems come pre-assembled and tested, cutting project timelines by as much as 30–50%. These systems are built in controlled environments, often while on-site preparations are still underway, which significantly reduces noise and dust during installation. For schools, this means shorter disruptions and a faster return to normalcy.
Decentralized systems provide even more flexibility. For example, Bard factory-packaged units allow maintenance teams to replace up to six units over a single weekend, avoiding interruptions during the school week [8]. Wall-mounted systems eliminate the need for invasive above-ceiling ductwork, and certain high-capacity units can be split into two parts to fit through standard 36-inch doorways and elevators. This avoids the need for tilting or making structural changes [8].
"Bard factory-packaged systems can be installed by smaller crews with broader skill ranges, meaning your school can move forward without waiting for electrical, fire suppression, or other contractors to finish."
Take Lee County Public Schools in Virginia as an example. Faced with tight budgets and limited construction windows, they retrofitted older buildings with Bard exterior wall-mount heat pumps. This approach provided climate control and improved indoor air quality without a full HVAC overhaul or major structural changes [1]. The result? Lower costs and faster installation with minimal disruption.
Once you’ve streamlined the setup process, the next step is ensuring the new system integrates seamlessly with existing infrastructure.
Check Compatibility with Existing Systems
Ease of installation isn’t just about speed – it’s also about making sure the new equipment works well with your current setup. To minimize disruptions and keep operations running smoothly, verify that the new HVAC equipment is compatible with your building’s infrastructure.
Start by checking electrical capacity. Your building’s current electrical system might not support the demands of new cooling equipment without upgrades [10]. Also, confirm that the new units can integrate with your Direct Digital Controls (DDC) or building automation systems. If platforms don’t align, maintenance can become unnecessarily complicated [3].
"Going from a pneumatic control system to direct digital controls is a major change, and staff might not understand or be qualified to operate the new system."
- Nicholas Neiley, Senior Engineer, Horizon Engineering [3]
In September 2025, Saskatoon Public Schools faced a similar challenge. Instead of replacing old rooftop units with costly digital scroll systems, they implemented APR Control, a mechanical capacity modulation solution. This allowed the district to improve performance and energy efficiency while keeping compatibility with their existing contractor-friendly infrastructure [9]. The key takeaway? Choose systems with plug-and-play configurations and non-proprietary components – like fans, coils, and filters – that are easy to source locally. This simplifies both installation and long-term maintenance.
Control Noise During Construction
Managing construction noise is key to maintaining a productive learning environment during HVAC upgrades. Even with careful scheduling and equipment choices, noise can disrupt classroom acoustics – causing students to miss 20–30% of what teachers say. This issue is even more pressing when you consider that up to 25% of students on any given day may already face temporary hearing challenges from conditions like ear infections [15].
Here are some practical ways to keep noise under control during construction.
Apply Noise-Reducing Construction Methods
One effective strategy is to work closely with school administrators to schedule the noisiest tasks – like drilling, cutting, or equipment installation – outside of teaching hours. Curtis DeLaquil, Group Manager at JE Dunn Construction, highlights the importance of understanding school routines:
"Coordinating with administration to understand these patterns, then planning accordingly, can ensure a seamless partnership and minimal disruption to the campus" [7].
In addition to scheduling adjustments, physical measures can help contain noise. For instance, swing spaces – unused classrooms where students can temporarily relocate – can create distance between active construction zones and learning areas. A great example of this approach was the $16 million HVAC upgrade at Historic Hillsborough High School in Tampa, Florida. JE Dunn Construction worked with school administrators to rotate six classrooms at a time through swing spaces. This phased plan allowed the team to replace a central energy plant, 17 air handlers, and 157 air volume control units during the school year, all without disrupting classes [7].
To further reduce noise, consider simple yet effective solutions like door sweeps and perimeter seals to block sound leaks through air gaps. Use acoustical caulk to seal drafts around windows and doors. For mechanical systems, install flexible duct and pipe connections at motors, fans, and compressors to break vibration paths before they travel through walls and ceilings [11][13]. Additionally, vibroacoustic isolators can absorb up to 99% of vibrations, significantly reducing noise from equipment [14].
Install Quiet HVAC Systems
Once construction is complete, the new HVAC system itself should enhance, not harm, the classroom environment. The ANSI S12.60-2002 standard recommends a maximum background noise level of 35 dBA for permanent classrooms [12][15], yet many older systems exceed this limit.
Modern HVAC systems tailored for schools are much quieter. Look for features like low-sound level fans and Variable Refrigerant Flow (VRF) systems, which offer quieter operation and better zoning control [11][17]. A prime example is Central Elementary School in Dodge City, Kansas, where noisy window air conditioners were replaced with a water-source VRF and geothermal system in 2012. Managed by Drew Rose of Integrated Consulting Engineers, the project transformed a 1927 brick building into a quiet learning space. Teachers no longer had to turn off the air conditioning to be heard during lessons [17].
Placement also plays a big role in noise control. Position HVAC units near buffer spaces like bathrooms, storage rooms, or corridors to minimize sound in classrooms [14][16]. Adding one- to two-inch fiberglass duct liners can absorb 70–90% of common sound frequencies [15]. If placement and liners aren’t enough, consider installing duct silencers or sound attenuators, ensuring a pressure drop of no more than 0.15" WC [11].
| Space Type | Maximum Recommended Sound Level (NC) |
|---|---|
| Classrooms | 35 (30 Recommended) |
| Performing Arts | 25 |
| Library/Media Center | 35 |
| Private Office Areas | 35 |
| Athletic Spaces | 45 |
(Source: Chicago Public Schools Design Criteria) [11]
Maintain Comfortable Temperatures During Upgrades
When upgrading HVAC systems, keeping classrooms comfortable is a top priority. Even with careful planning, temporary disruptions in climate control can happen. To address this, using temporary equipment and managing zones strategically ensures that comfort is maintained while permanent systems are installed.
Use Portable Heating and Cooling Units
Temporary heating and cooling equipment is a practical solution to bridge the gap when old systems are removed, and new ones are not yet operational. Rental HVAC systems – like chilled water systems, cooling towers, and rooftop units – can keep the building comfortable during major renovations. Mike Conklin, Marketing and Sales Leader at Trane Rental Services, emphasizes this point:
"Renting chilled water systems and components, cooling towers, rooftop air conditioners, air handlers, power generators, or other systems and equipment enables facilities managers to provide uninterrupted service and ensure the comfort of students, teachers and staff during the renovation process" [18].
In heat-sensitive areas like computer labs and libraries, portable spot coolers and multifunctional heat pumps are especially effective [19]. For example, Redwood City School District successfully combined rental and purchase options to maintain comfort during phased upgrades [20].
Sometimes, unexpected delays in permanent system installations make rental equipment indispensable. A good example is Volusia County Schools, which rented four 400-ton air-cooled water chillers when their permanent systems were delayed. This allowed both a high school and a middle school to open on time while maintaining climate control until the permanent systems were ready [18].
Separate Construction Zones from Active Classrooms
In addition to temporary equipment, separating construction zones from active classrooms helps maintain a stable environment. Physical barriers between work areas and occupied spaces ensure that classrooms in use can stay comfortable. A "swing space" strategy – where students rotate through unused rooms – can also help. Historic Hillsborough High School in Tampa, Florida, used this approach during a $16 million HVAC upgrade. By rotating students through six classrooms at a time, they replaced air handler units without disrupting instruction [7].
For schools dealing with cooling challenges during upgrades, simple measures can make a big difference. In 2024, Long Beach Unified School District tackled heat in 13 schools awaiting HVAC installations by installing chilled water dispensers in non-air-conditioned classrooms, repairing window coverings to create thermal barriers, and using pedestal fans in hallways and portable fans in classrooms [22]. These cost-effective steps helped maintain comfort until permanent systems were installed.
Decentralized HVAC systems offer another advantage during upgrades. With each classroom having its own wall-mounted unit, work on one area doesn’t impact the entire building. This allows most classrooms to continue operating under normal conditions while specific areas undergo renovation [21].
Work with Professional Design-Build Contractors
After selecting equipment and implementing noise control measures, partnering with experienced contractors ensures HVAC upgrades are completed smoothly without disrupting school operations. Professional design-build contractors specialize in coordinating projects to minimize classroom disturbances. By syncing construction timelines with the school calendar, they help maintain an uninterrupted learning environment. At E3 Design-Build Contractor, we focus on energy-efficient facility solutions, carefully planning upgrades around school schedules, complex logistics, and strict safety measures to ensure the safety of students and staff during construction.
Use Expertise in School Facility Upgrades
Design-build contractors provide a seamless process by combining both design and construction under one point of responsibility. This method offers schools a fixed lump-sum price with no unexpected change orders, ensuring budget predictability from the outset [23]. Contractors also tailor their plans to avoid conflicts with testing periods, special events, and peak traffic times [7].
Take the example of Polk County High School in North Carolina. Between summer 2021 and late 2022, Brady Services undertook an HVAC overhaul, replacing an outdated two-pipe system with air-cooled chillers and variable air volume (VAV) boxes. The team worked in batches of four to five classrooms, scheduling the most disruptive tasks at night to minimize interference. By choosing ultra-quiet Trane ACRB chillers, the project also earned a $155,176 rebate [23]. Dr. Brandon Schweitzer, Director of Operations at Polk County Schools, highlighted their efforts:
"Brady worked above and beyond to accommodate our school schedule and stay as hidden away from day-to-day operations as possible. They met all our scheduling and operational requirements" [23].
Additionally, contractors ensure all workers are screened and follow strict safety protocols. Measures such as negative-pressure containment and HEPA-filtered air scrubbers are implemented to prevent construction contaminants from entering active learning areas [24][5]. This coordinated approach simplifies decision-making and reduces on-site challenges, complementing earlier strategies.
Simplify Project Planning and Execution
Professional contractors streamline the entire process – scheduling, budgeting, and material staging – ensuring that all equipment with long lead times is ready before critical construction windows. This meticulous planning helps prevent delays and ensures maximum efficiency, allowing classrooms to operate without interruptions.
Jake Nellis, Vice President at JE Dunn’s Tampa Office, emphasized:
"Pre-planning is critical to success. Having the right supplies and equipment staged and ready allows teams to hit the ground running and finish work before staff and students return" [7].
Beyond logistics, contractors assist schools in navigating complex funding solutions like Energy Performance Contracting (EPC). This financing model uses projected energy savings to fund current upgrades, eliminating the need for upfront costs. They also help identify utility incentives to lower project expenses while boosting system efficiency.
Conclusion
HVAC upgrades don’t have to disrupt classrooms. With smart planning, schools can schedule work during breaks or off-peak days, ensuring minimal interference. Breaking projects into smaller phases helps keep the rest of the building functional while improvements are made.
Choosing equipment that’s quick to install is equally important. Modern wall-mounted units and modular systems speed up the process by eliminating the need for extensive ductwork. This approach not only saves time but also aligns perfectly with a well-thought-out schedule. Adding noise-reduction measures and quieter HVAC technology ensures comfort throughout the process. Considering that about 40% of U.S. school districts report at least half of their buildings need HVAC upgrades [1], these strategies are crucial for facility managers.
Temporary solutions, like portable HVAC units and HEPA-filtered air scrubbers, help maintain safe temperatures and air quality during the work. These steps ensure students and teachers aren’t left in uncomfortable or unsafe conditions.
To tie everything together, professional design-build contractors bring expertise in logistics, code compliance, and scheduling. Starting the planning process early – ideally in the fall for summer projects – helps schools account for equipment lead times and avoid unnecessary delays. With careful coordination, schools can achieve needed upgrades without interrupting education.
FAQs
How far ahead should we start planning an HVAC upgrade?
Planning an HVAC upgrade should ideally begin 6 to 12 months ahead of time. This gives you enough room to handle tasks like ordering equipment, managing items with long lead times, and scheduling the work during less disruptive periods – think summer vacations or holiday breaks. Starting early ensures a smoother process and reduces the chance of interrupting classes.
What temporary cooling or heating works best during construction?
When it comes to finding the right temporary cooling or heating solutions during construction, it all boils down to the facility’s specific needs and the project’s scope. Options like portable and modular systems – such as air-cooled chillers, packaged units, or portable heaters – are popular choices because they’re flexible and effective.
For smaller spaces like classrooms, wall-mounted AC units work well. They’re easy to install and simple to control, making them a hassle-free option. On the other hand, larger areas might need something more robust, like portable chillers or rooftop units, to provide consistent comfort without causing major disruptions.
How do we keep indoor air quality safe while HVAC work is happening?
To keep indoor air quality (IAQ) safe during HVAC work, focus on a few key strategies. Use proper filtration systems, increase ventilation, and consider portable air cleaners to tackle airborne contaminants. Schedule upgrades during off-hours or times when fewer people are present to minimize exposure risks. Maximize outdoor air intake and inspect filtration systems at every stage – before, during, and after the work. These practices help reduce airborne pathogens and maintain a healthier indoor environment throughout the process.
